Project Duration from an Activity Network
Mediumproject controlscritical pathscheduling

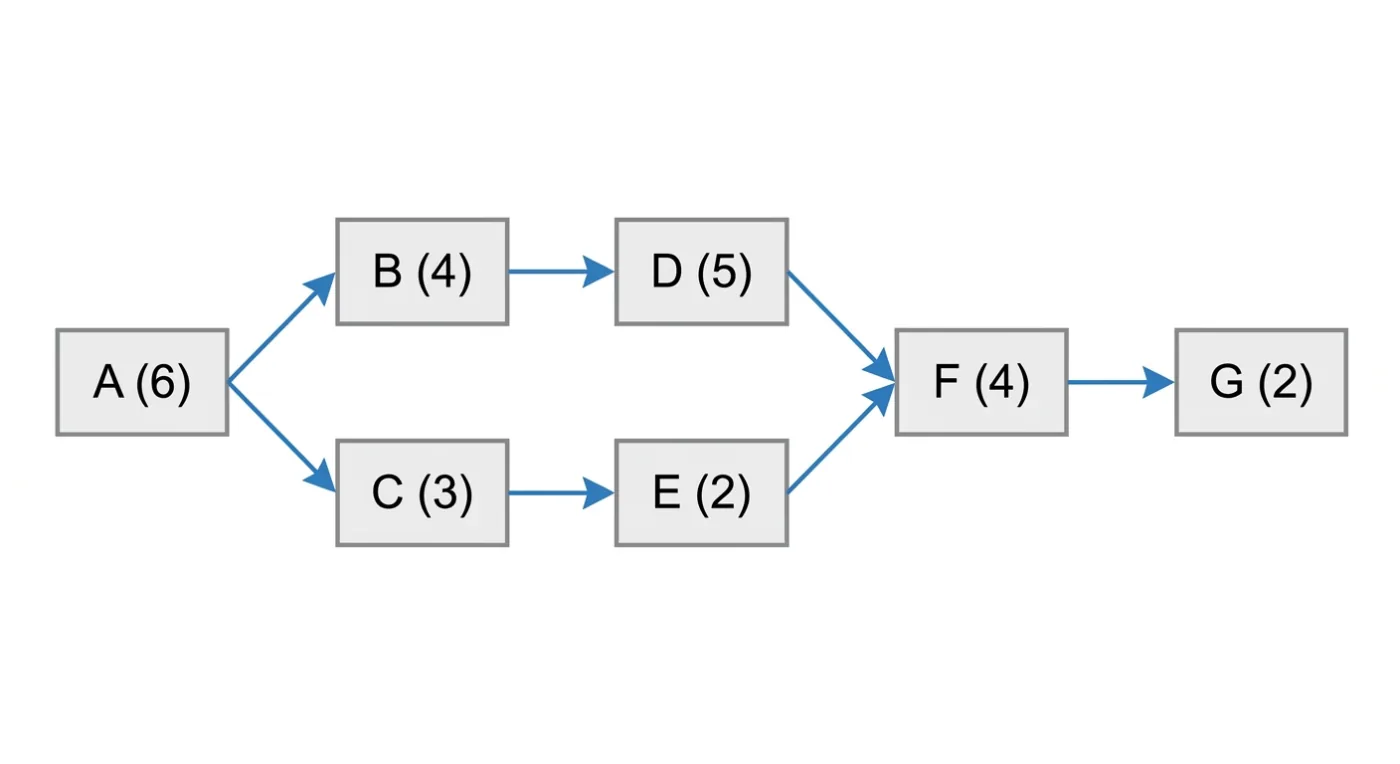

An activity-on-node schedule has activity A (6 days) followed by both B (4 days) and C (3 days). B is followed by D (5 days) and C is followed by E (2 days). Both D and E precede F (4 days), which is followed by G (2 days). The critical path duration is most nearly:
- A15 days
- B17 days
- C21 days
- D26 days
Show solutionHide solution
Answer: C. 21 days
Enumerate the paths through the network. A-B-D-F-G = 6 + 4 + 5 + 4 + 2 = 21 days. A-C-E-F-G = 6 + 3 + 2 + 4 + 2 = 17 days. The critical path is the longest, so the project duration is 21 days and the second path carries 4 days of float. Adding every activity duration gives 26 days, which would only apply if no work ran in parallel.
Practice this deckUntimed, one problem at a time, with your progress saved.
Related problems
- Project Duration from Critical Path · Construction & Scheduling
- Total Float of a Schedule Activity · Construction & Scheduling
- Cost Performance Index from Earned Value · Construction & Scheduling
